Skip to content

00 /How It Works

From open plan to sent invoice, without re-entering anything.

The whole system exists so a number typed once at the truck becomes the daily report, the weekly total, and the invoice automatically.

VORO populated production map workspace
01 · Map
VORO daily production dashboard
02 · Daily
VORO production invoice
03 · Invoice

STEP 01

Open

Open the project and construction plan

Projects hold their plans, and plans hold the network: runs, boxes, handholes, vaults. What's completed is already drawn on the map in green, so the starting point is never a blank form.

VORO construction plan with real completed underground fiber runs, footage, conduit labels, and structures
01 · Open the plan

STEP 02

Record

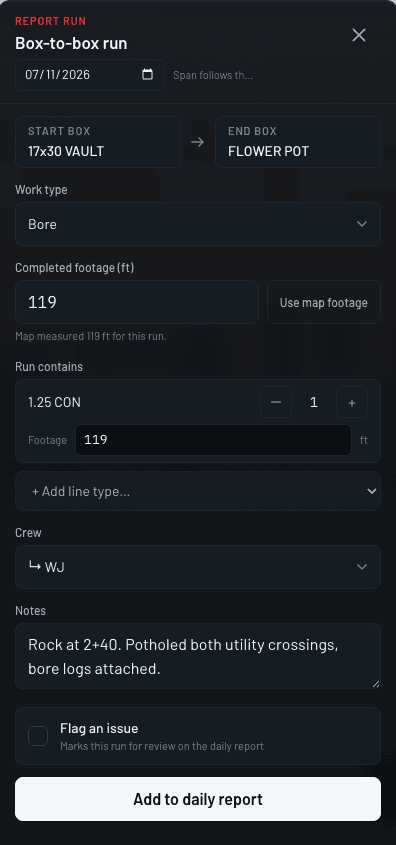

Record completed production from the map

Select the completed run from box to box, then enter the footage, conduit, crew, and date. Add a note if the day had one (rock, standby, a lid on order). If the run was already recorded, VORO says so instead of taking a duplicate.

VORO box-to-box run editor showing footage, conduit, crew, notes, issue flagging, and remove controls
Click a completed run

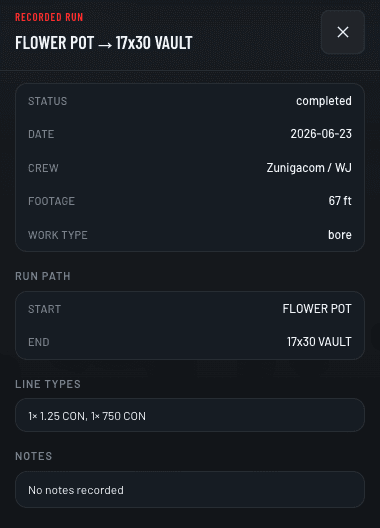

VORO structure panel showing reported status, work date, crew, field notes, and review controls
Click a placed structure

STEP 03

Review Daily

Review footage, crews, dates, and notes

The daily view shows every crew's production with its status. Supervisors verify entries the same day, flag anything that needs review, and see missing production while it's still cheap to fix.

VORO daily dashboard reviewing footage and production by crew
03 · Review daily

STEP 04

Roll Up

Weekly totals build themselves

Daily records aggregate by crew and plan into weekly totals. By the end of the week the numbers are already assembled, so the job is reading them, not rebuilding them.

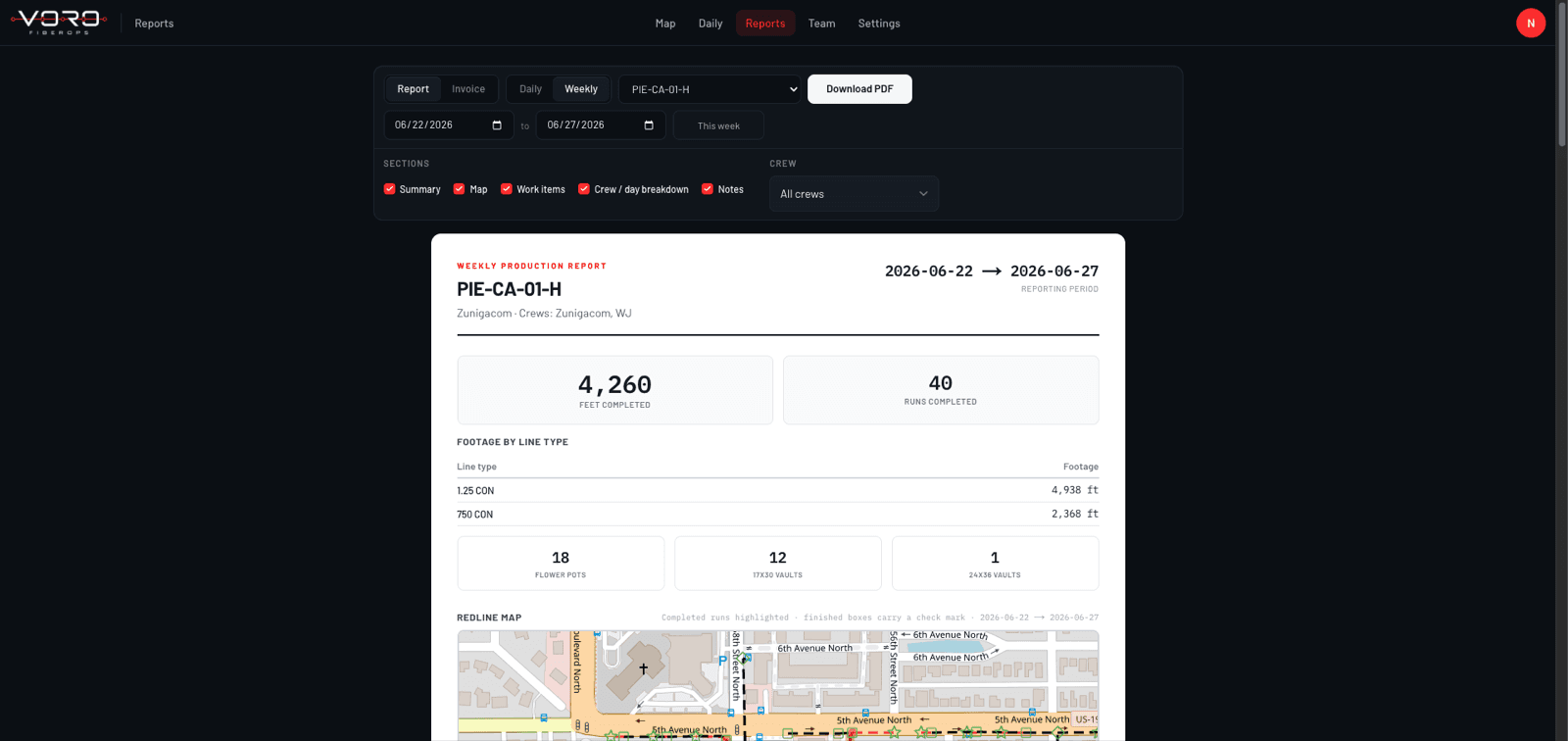

VORO production report with footage and completed work totals
04 · Roll up the week

STEP 05

Report & Invoice

Reports and invoices from the same records

The weekly report and the invoice quantities are generated from verified production: footage by conduit type, boxes set, and the period they belong to. The footage on the invoice will match the numbers on the map.

VORO invoice built from the same verified production records
05 · Report and invoice

Book a demo

Watch it happen on a real plan.

The demo is this exact walkthrough, live. Record a run and follow the same footage to the daily report, the weekly totals, and the invoice.

No commitment. About 30 minutes.
